Deck Permit Drawings: 3 Sheets and a Worked 16x12 Deck

Oleh Onysko 16 October 2026 13 min read

ScaledPlans · Field notesGet started
Plans in. Quantities out.Get started
Partly built wooden deck frame attached to the back of a house, joists on a beam over concrete footings

Deck permit drawings are usually three sheets: a site plan that places the deck on the lot, a framing plan that sizes the joists, beams, posts and footings, and details for the ledger, guards and stairs. If every member on those sheets carries a species, size, spacing and table reference, a reviewer can check your deck without calling you.

One rule trips up a lot of first drawings. The joist overhang limit in the American Wood Council's DCA 6 guide is not a flat 2 ft. It is the smaller of the table value and one quarter of the actual joist span. Shorten the span and the overhang you are allowed can shrink with it, so check both numbers every time.

Deck permit fact What it means for you
Sheets Site plan, framing plan, connection details
Common reference AWC DCA 6 prescriptive deck guide
Overhang limit Smaller of the table value and span / 4
Guard trigger (example office) Surface more than 30 in above grade
Worked example 16 x 12 ft ledger deck, 192 sq ft, 13 joists
Who decides Your permit office and its adopted code edition

What deck permit drawings include

A residential deck application normally asks for a placement drawing, a framing layout and construction details. Each one answers a different question.

  • Site plan: where does the deck sit relative to the house and lot lines?
  • Framing plan: what holds it up? Joist size and spacing, beam size, post locations and footing sizes.
  • Details: how does it connect? Ledger fastening, lateral attachment, guard posts, stair stringers and handrails.

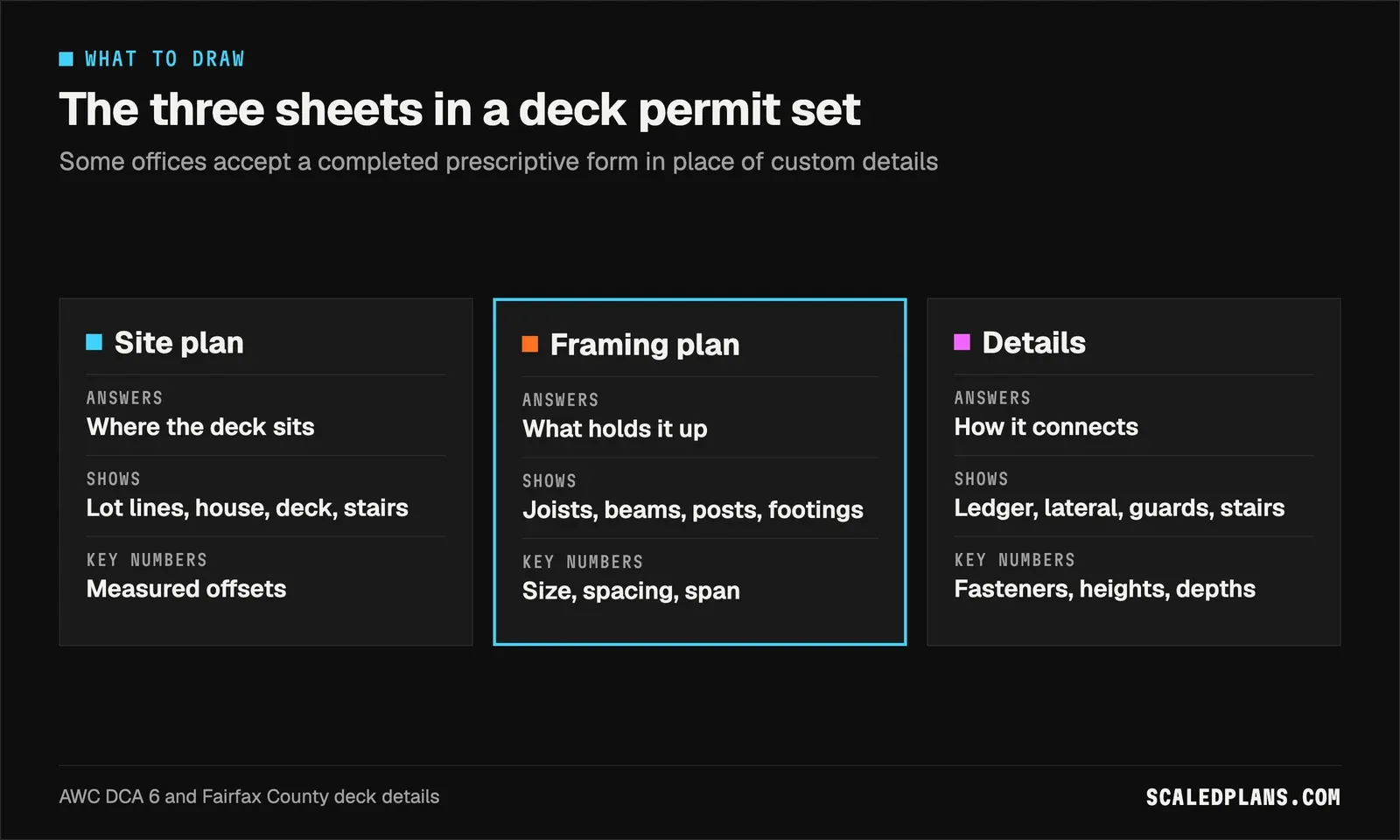

Comparison of the site plan, framing plan and details sheets: what each answers, shows and dimensions
Three sheets, three different questions

Some offices accept a completed prescriptive form instead of custom details. Fairfax County, Virginia, is a good example. Its Typical Deck Details handout, based on the 2021 Virginia Residential Code, ends with a "Complete My Deck" page where you tick decking, joist, beam, footing, post, ledger and lateral support choices and sketch the deck. The county wants that page on site at every inspection. Other offices want the same facts on your own sheets, so ask which format they accept before you draw.

Whatever the format, put dimensions on everything and name species, grade and fasteners. Once your set grows past one page, the blueprint reader guide explains how sheets, sections and callouts point at each other.

Deck plans for permit: the site plan sheet

The site sheet shows the lot lines, the house footprint, the deck outline with overall dimensions, the stairs and landing, and the measured distance from the deck to each relevant lot line. Label those distances as measured and list the required setbacks from your zoning office separately. The site plan for permit guide covers boundary sources and offset labels in depth, using the same 16 x 12 ft deck: 192 sq ft, 10 ft from the left line and 24 ft from the rear. If you have never drawn one, start with the site plan basics: what goes on the sheet and how to work out lot coverage.

Draw the stairs as their own outline. DCA 6 leaves stairs and landings out when it measures overall deck length and width, so a reviewer wants to see them separately. Mark known utilities and septic parts too: DCA 6 says not to put footings over septic systems, leach fields, utility lines or enclosed meters, and to call 811 before you dig. Showing footing locations on the site sheet makes those conflicts visible early.

The deck framing plan: joists, beams and posts

DCA 6 defines a framing plan as a drawing of the deck width and length, the joist and beam layout, the ledger, post and footing locations, and the type, size and spacing of the ledger fasteners. Use that list as your sheet checklist, draw it to scale in plan view, and call out every beam with its ply count and size.

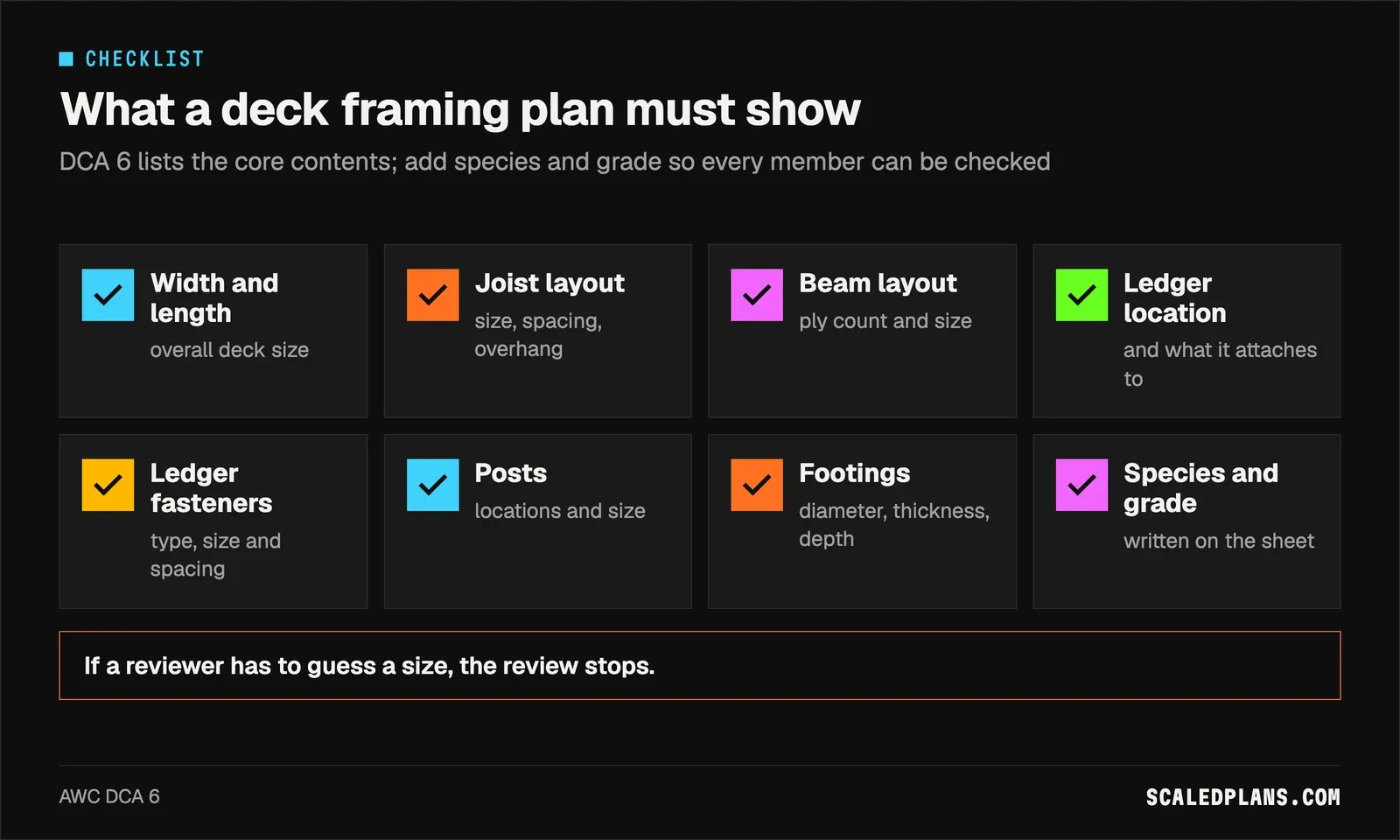

Checklist of eight framing plan items from deck size to lumber species and grade
Eight things the framing plan must show

Three DCA 6 rules shape the framing plan:

  • Span is face to face. Joist span runs from the face of one support to the face of the other and does not include the overhang. Table 2 lists allowable spans by species, size and spacing, assuming 40 psf live load, 10 psf dead load, No. 2 grade and wet service.
  • Scope limits. The prescriptive method covers single level decks attached to the house, with overall length no more than overall width, and 6x6 as the minimum post size.
  • Posts and footings come from Table 4, which pairs beam span and joist span with post height limits and footing size.
Deck plan sheets on a sawhorse table beside a stack of pressure treated joists
Write species, size and spacing on the sheet

Draw the plan with member lengths you can actually buy. The lumber takeoff guide turns a finished framing plan into a cut list, and the framing calculator is handy for checking member counts once the layout is fixed. If the deck steps off a converted garage, the permit to convert a garage into living space is its own application with its own sheets.

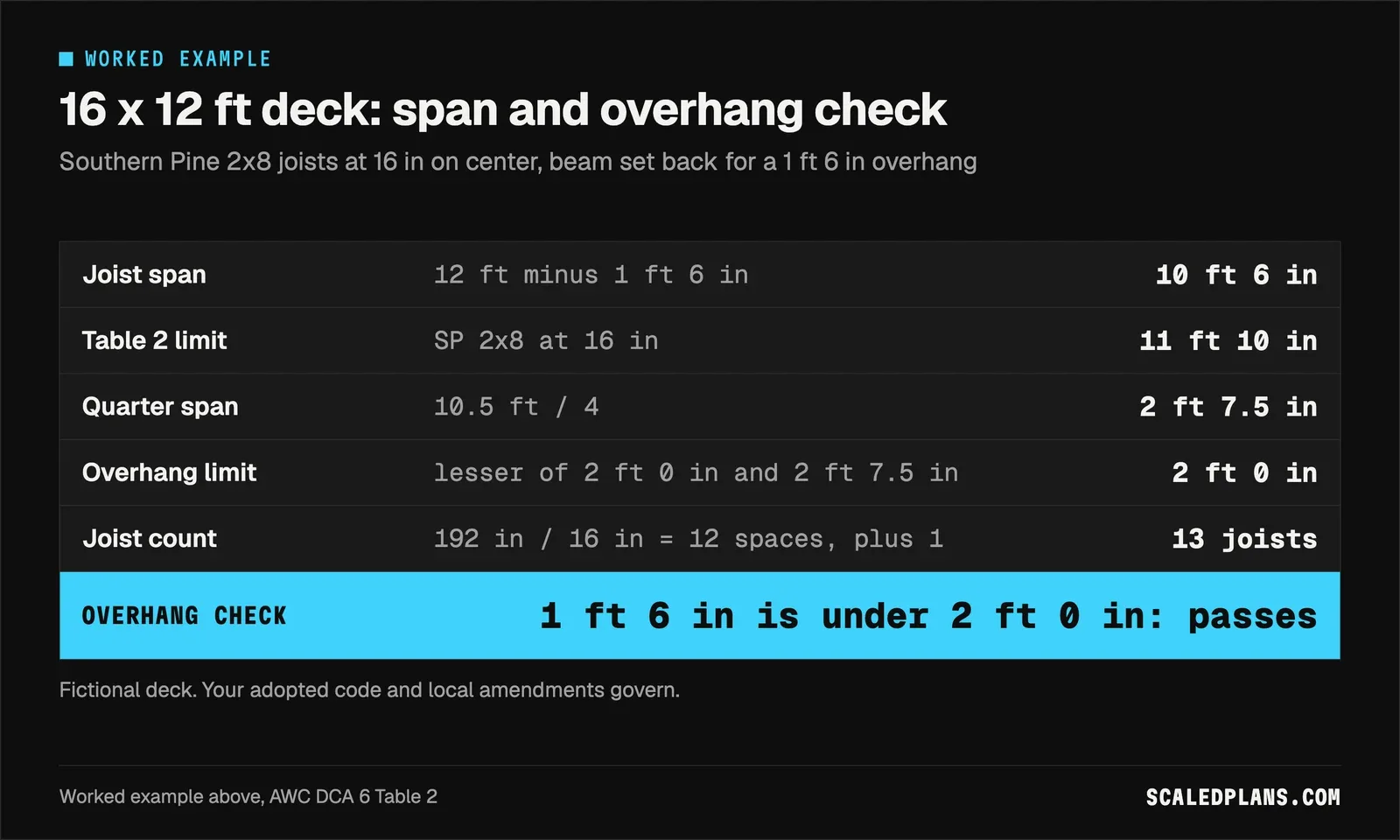

Worked example: a 16 x 12 ft ledger deck in Southern Pine

This fictional deck is 16 ft wide along the house and projects 12 ft. The surface sits 38 in above flat grade. The beam is set back so the joists overhang 1 ft 6 in (beam width ignored for this sketch). Joists are Southern Pine 2x8 at 16 in on center.

Check Calculation Result
Deck area 16 x 12 192 sq ft
Length vs width 12 ft projection, 16 ft width Within DCA 6 limit
Joist span 12 ft minus 1 ft 6 in 10 ft 6 in, under 11 ft 10 in
Overhang limit lesser of 2 ft 0 in and 10.5 / 4 2 ft 0 in; 1 ft 6 in passes
Joist count 192 in / 16 in = 12 spaces, plus 1 13 joists
Footings posts at 0, 8 and 16 ft; Table 4 3 footings, 24 in round, 10 in thick

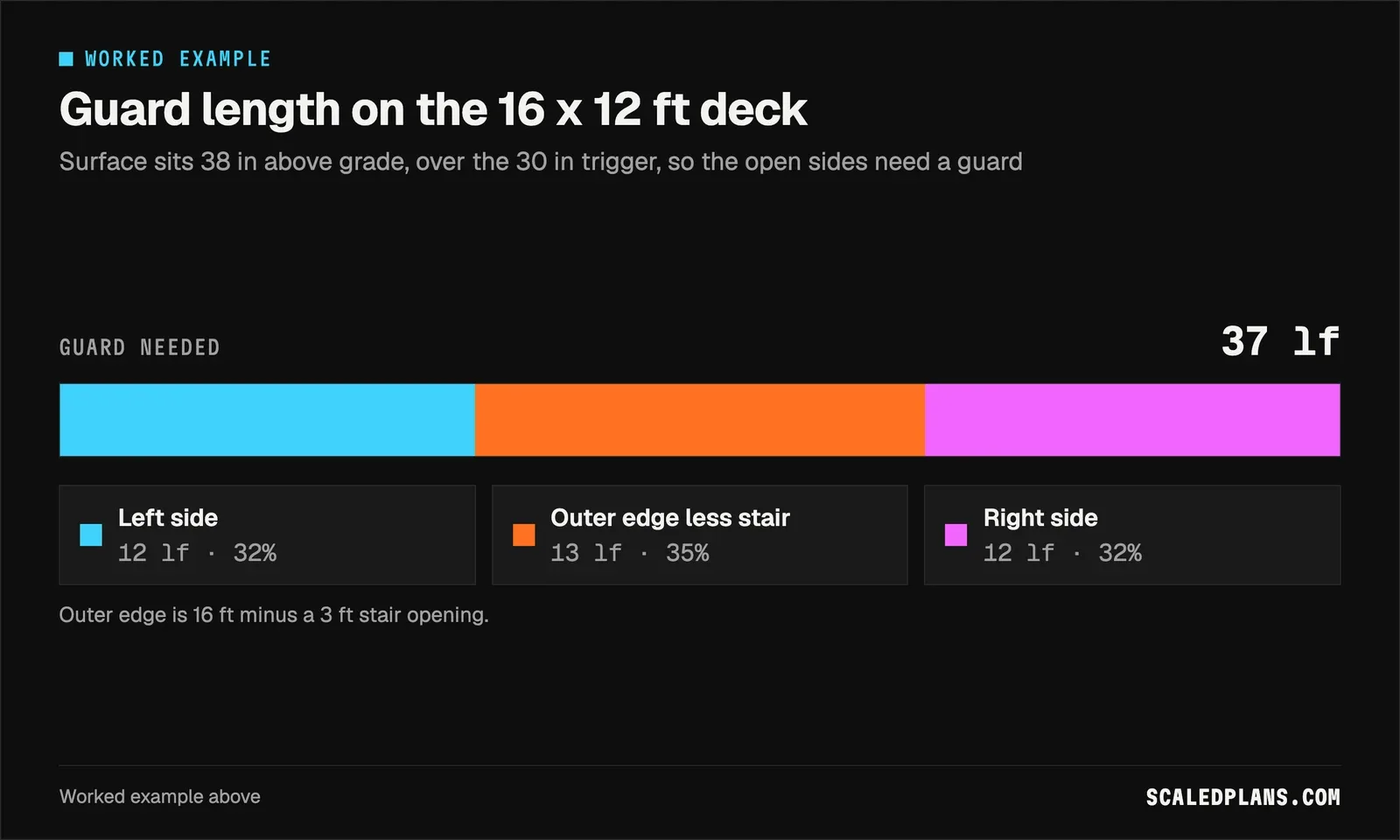

Guard 38 in is over 30 in; 12 + 16 + 12 minus 3 37 lf
Stairs 38 in / 5 risers 7.6 in risers, 4 treads

Walk the overhang line slowly. Table 2 allows 2 ft 0 in for this joist. A quarter of the 10 ft 6 in span is 2.625 ft, or 2 ft 7.5 in. The smaller number governs, so the limit is 2 ft 0 in, and the 1 ft 6 in overhang passes. On a smaller deck with a 7 ft joist span, a quarter of the span is only 1 ft 9 in, so that becomes the limit instead of 2 ft 0 in.

Formula card: 10 ft 6 in joist span under the 11 ft 10 in limit, overhang limit 2 ft 0 in, 13 joists
The smaller overhang limit always governs

Three posts at 0, 8 and 16 ft give two 8 ft beam spans. Size the beam from DCA 6 Table 3 for those spans. For an 8 ft beam span and joists up to 14 ft, Table 4 lists a 24 in round or 21 x 21 in square footing, 10 in thick. With five risers, the stair has four treads, and four or more risers means a handrail.

Stacked bar of guard length: 12 lf left, 13 lf outer edge after the stair opening, 12 lf right, 37 lf total
37 lf of guard after the stair opening

How to draw deck permit drawings

  1. Get your office's deck handout

    Ask whether they accept a prescriptive form, which code edition they use, and their local footing depth.

  2. Place the deck on the lot

    Draw lot lines from your survey, the house, the deck and the stairs. Dimension measured offsets and list required setbacks separately.

  3. Size the framing from tables

    Pick species, joist size and spacing, then check span, overhang, beam span, post height and footing size against the tables.

  4. Draw the connection details

    Add sections for the ledger and flashing, lateral hold downs, footings, guard posts and stairs, with fastener types and spacing.

  5. Review the set before you submit

    Confirm every member has a size and table reference, and every sheet shows the same deck dimensions.

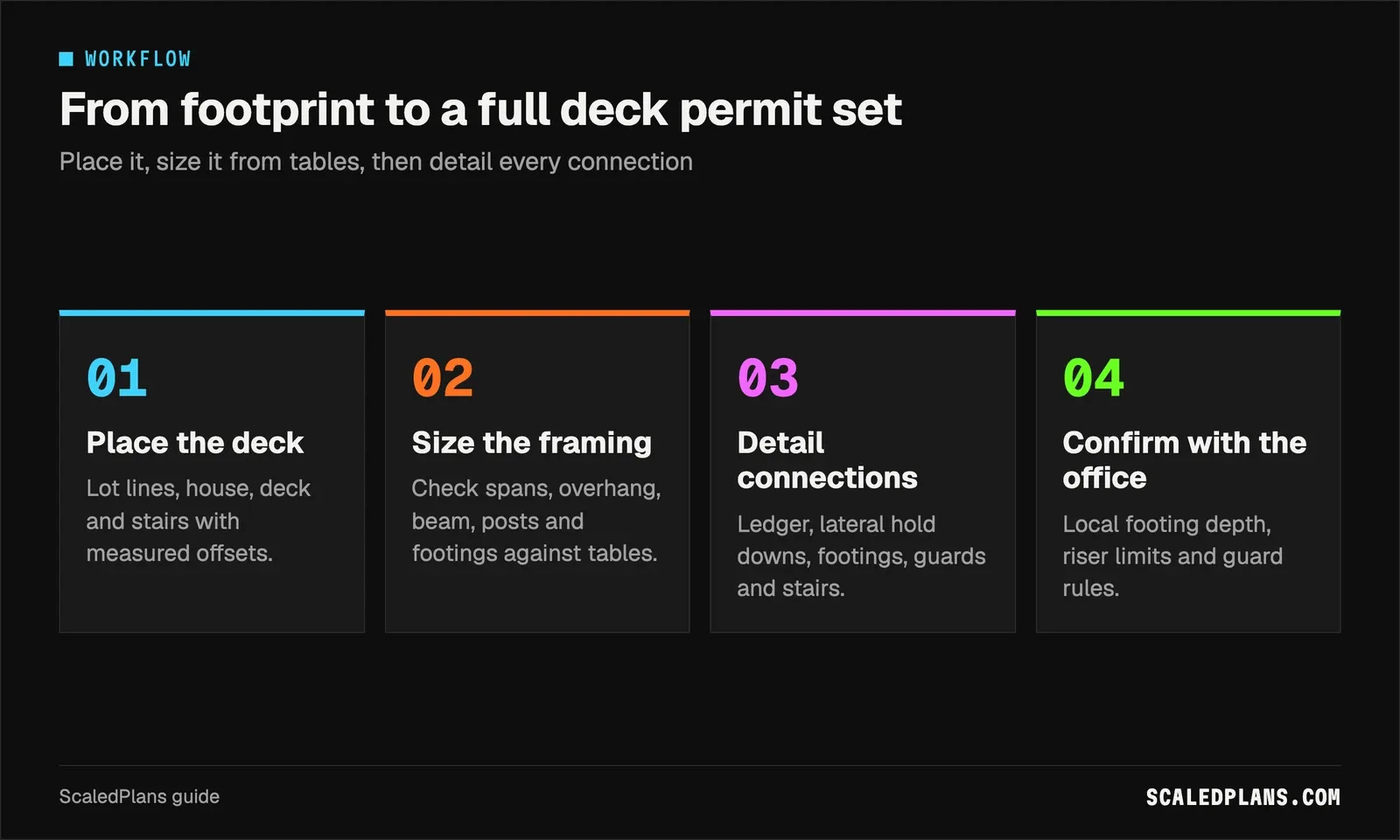

Four step workflow: place the deck, size the framing, detail connections, confirm with the office
Place, size, detail, confirm

Ledger, lateral load and footing details

The ledger detail gets close review. DCA 6 requires a ledger of at least 2x8 nominal and prohibits attaching it to brick or stone veneer, hollow masonry, cantilevered floor overhangs or bay windows. In those cases the deck must stand on its own beam at the house. Lead anchors are prohibited. Draw the ledger section with the band joist, sheathing, flashing and the fastener type and spacing from the ledger fastener table for your joist span.

Carpenter in safety glasses seen from the side fastening a flashed ledger board to a house band joist
The ledger detail gets close review

Lateral attachment needs its own callout. DCA 6, referencing IRC R507.2.4, calls for hold down tension devices in at least two places within 2 ft of the deck edges, each rated at least 1,500 lb. Show what they fasten into inside the house, because the reviewer cannot see the floor framing from your deck sheets. If the ledger work means pulling back cladding, the siding calculator helps you reorder what gets replaced.

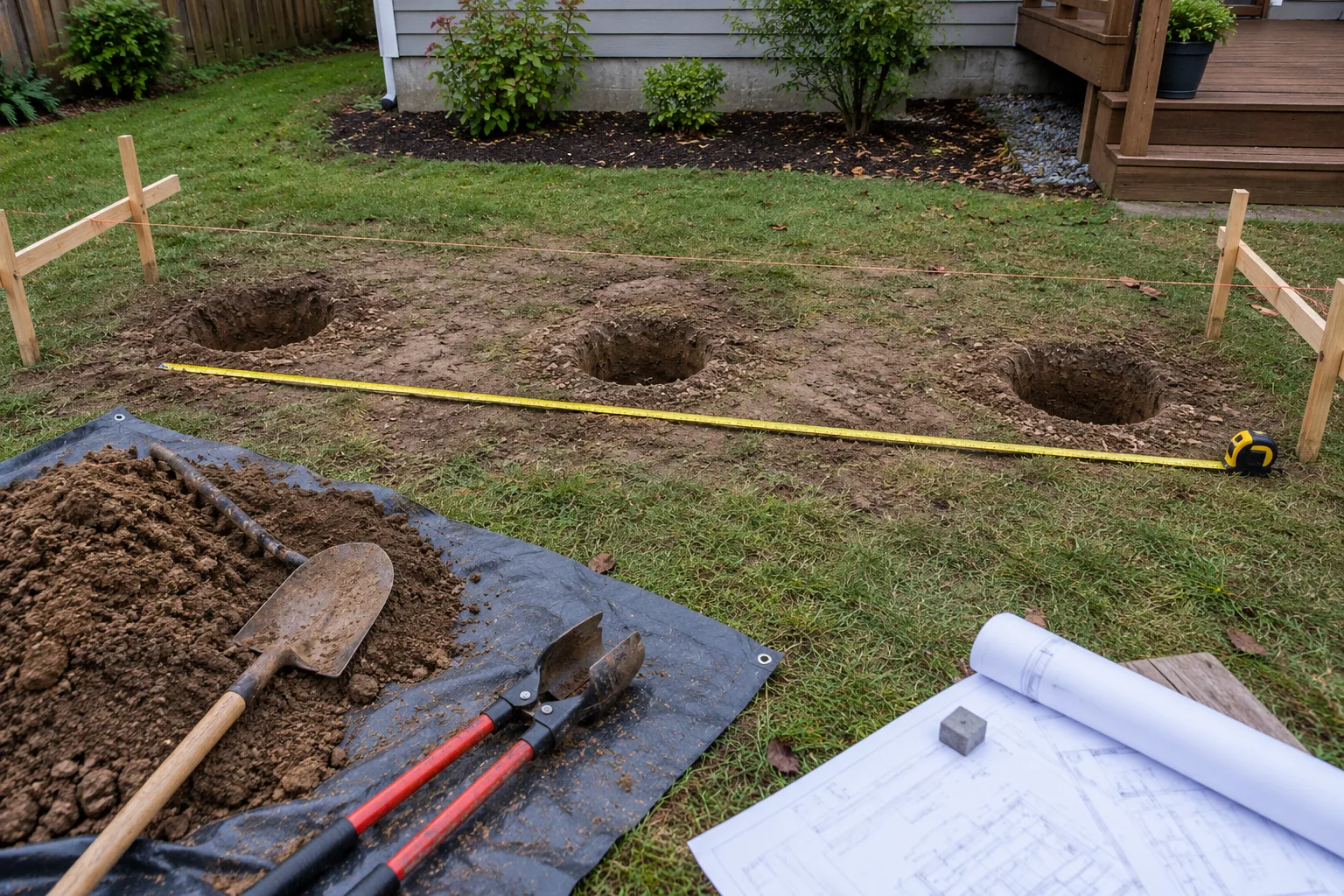

Footings in DCA 6 bear on undisturbed soil at least 12 in below grade or below the frost line, whichever is deeper. A footing closer than 5 ft to the house foundation must bear at the same elevation as the house footing. Many offices go deeper; Fairfax requires 24 in. Write your office's depth on the section, and call for hot dip galvanized hardware (G-185) or stainless steel, with grade 304 or 316 stainless within 300 ft of salt water.

Three dug footing holes in a row with a tape measure stretched along them in a backyard
Footing holes dug for the first inspection

Deck plans by situation

Situation What to do
Single level, attached, simple rectangle Prescriptive guide or county form, owner drawn if accepted
House has brick veneer or a cantilevered floor No ledger: draw a freestanding beam at the house
Deck surface over 30 in above grade Add guard elevation, post detail and 4 in sphere openings
Four or more stair risers Add handrail at 34 to 38 in and stair lighting
Hot tub, heavy snow or multi level Outside DCA 6: get a qualified professional design
Coastal site within 300 ft of salt water Specify 304 or 316 stainless hardware
Deck stair stringers and guard posts installed on a raised wooden deck, no balusters yet
Stairs and guards each have their own rules

Drawing deck plans by hand, and where it breaks

You can draw a full prescriptive set with graph paper, an architect scale and the DCA 6 PDF open beside you. Here is the manual order that works:

  1. Sketch the site plan from your survey at the lot scale.
  2. Redraw the deck alone at a larger scale, such as 1/4 in = 1 ft, and lay out joists at their spacing.
  3. Write the span and overhang check next to the joists, and the Table 4 footing next to each post.
  4. Draw the ledger, footing, guard and stair sections from the DCA 6 figures, filling in your sizes.
  5. Count the joists, beams, posts and hardware into a material list.

The wall comes at the first change. The owner wants the deck 2 ft deeper, so every span, the overhang check, the footing count, the guard length and the lumber list all move, and you redo each by hand. Nothing records which number came from which table, so the drawing and the order drift apart.

ScaledPlans measures the plan and lists the quantities, and you check every quantity before you price it. Get started when you want the drawing and the material list to stay in step. The rest of the free calculators cover the other trades on the same job.

Common deck permit drawing mistakes

  • Leaving species and grade off. Write them on the framing plan; spans mean nothing without them.
  • Using a flat 2 ft overhang. Check the smaller of the table value and span / 4.
  • Bolting a ledger to veneer. Brick, stone and cantilevers need a freestanding beam at the house.
  • Skipping lateral hold downs. Show two devices within 2 ft of the deck edges and what they fasten into.
  • Copying another county's footing depth. Use the depth your own office specifies.

What is the 3 4 5 rule for decks?

It is a way to square the deck to the house. Measure 3 ft along the ledger and 4 ft out along the first joist line; when the diagonal between those two marks reads exactly 5 ft, the corner is square. On a larger deck, scale it up to 6, 8 and 10 ft or 9, 12 and 15 ft for better accuracy.

How many footings do I need for a deck?

Count posts per beam, then multiply by the number of beams. Post spacing comes from the allowable beam span in the guide your office uses. On the 16 x 12 ft example, posts at 0, 8 and 16 ft on one beam give 3 footings; a wider deck or a shorter allowed beam span needs more.

Deck permit drawings are a site plan, a framing plan and connection details, with every member traceable to a table. The habit that matters most is writing species, size, spacing and the table you used beside every member, and checking the overhang against both of its limits. Try the framing calculator on your next layout, or Get started when you want the drawings and quantities in one place.

Frequently asked questions

Do I need drawings for a deck permit?

Most permit offices ask for drawings or a completed prescriptive form for an attached or raised deck. Expect a site plan that places the deck on the lot, a framing plan with joist, beam, post and footing sizes, and details for the ledger, guards and stairs. Some small or ground level decks are exempt in some places, so ask your local permit office what it needs before you start drawing.

Can I draw my own deck plans for a permit?

Many offices accept owner drawn deck plans when the design follows a prescriptive guide such as DCA 6 or a county deck handout. The drawings must be to scale, fully dimensioned and specific about species, grade, fasteners and hardware. Decks outside the prescriptive limits, such as multi level decks or decks carrying a hot tub, usually need design by a qualified professional, so confirm with your office first.

How do I draw a deck plan?

Start with the site plan from your survey, showing lot lines, the house, the deck and the stairs with measured offsets. Then draw the deck alone at a larger scale with joists at their spacing, beams, posts and footings, each labeled with size and species. Finish with section details for the ledger, footings, guards and stairs, using the figures in your office's deck handout as a model.

What should a deck framing plan show?

DCA 6 lists the contents: deck width and length, the joist and beam layout, the locations of the ledger, posts and footings, and the type, size and spacing of the ledger fasteners. Add the lumber species and grade, joist spacing, overhang, beam ply count, post size and footing dimensions, so a reviewer can check every member against a span table without guessing.

How deep do deck footings need to be?

DCA 6 requires footings on undisturbed soil at least 12 in below grade or below the frost line, whichever is deeper. Many jurisdictions set a greater local depth; the Fairfax County handout specifies 24 in. Footings within 5 ft of the house foundation must bear at the same elevation as the house footing. Ask your permit office for its required depth and write it on the footing detail.

Do I need an engineer for deck permit drawings?

A simple single level deck that follows a prescriptive guide often does not, if your permit office accepts that method. Decks outside the guide usually do. DCA 6 excludes large concentrated loads such as hot tubs and snow loads above 40 psf, and county handouts often exclude multi level decks that share posts and footings. Your permit office decides which decks need professional design.
